TEAM BLOG
Notes from the workshop and field
Verified design updates, flight evidence and the remaining path from the Kreosus baseline to Tulsa.

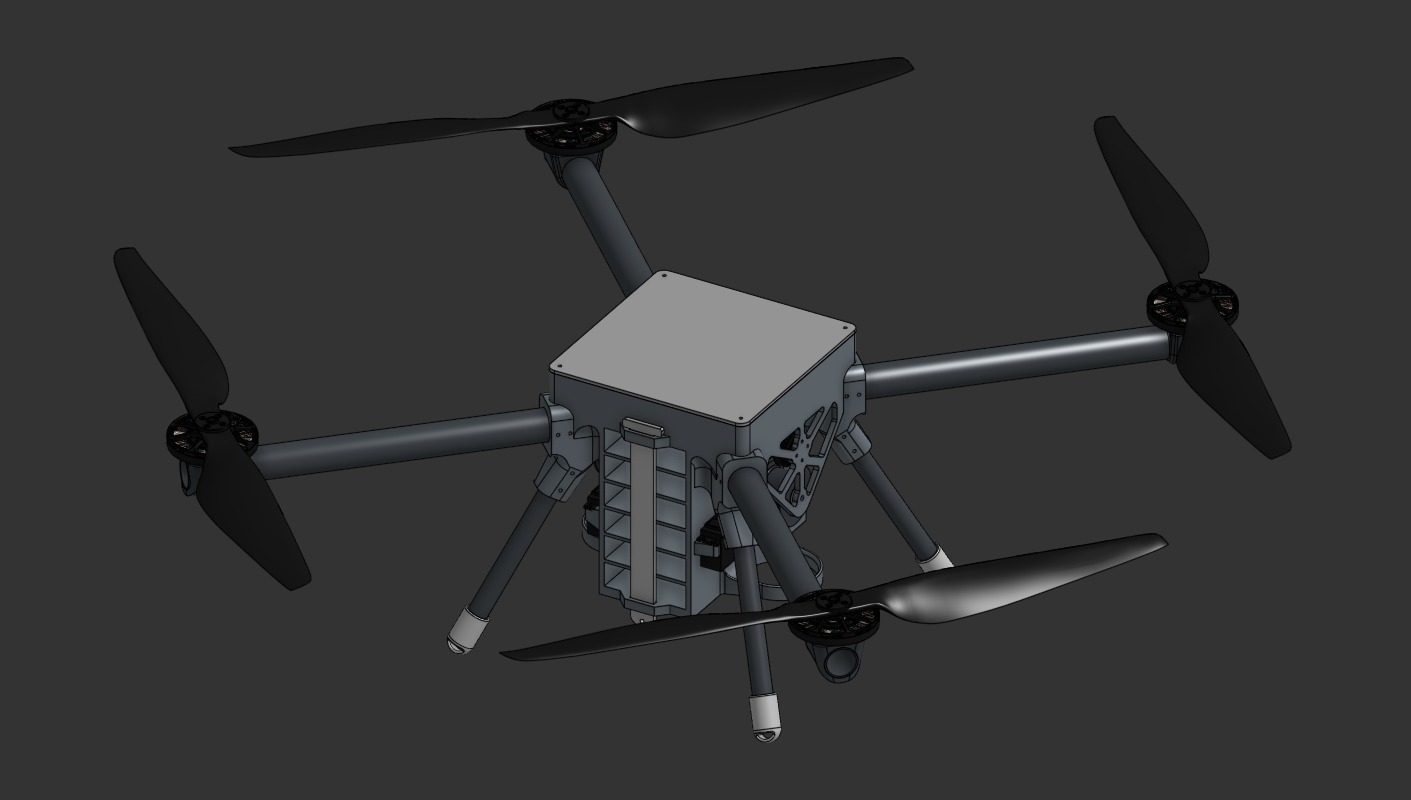

The Kreosus TDR is public
29 July 2026 | Design documentation
Our 2026 Technical Design Report now documents the complete aircraft baseline and its evidence boundaries.
The report connects mission requirements to trade studies, measured tests, flight results and failures that changed the design.

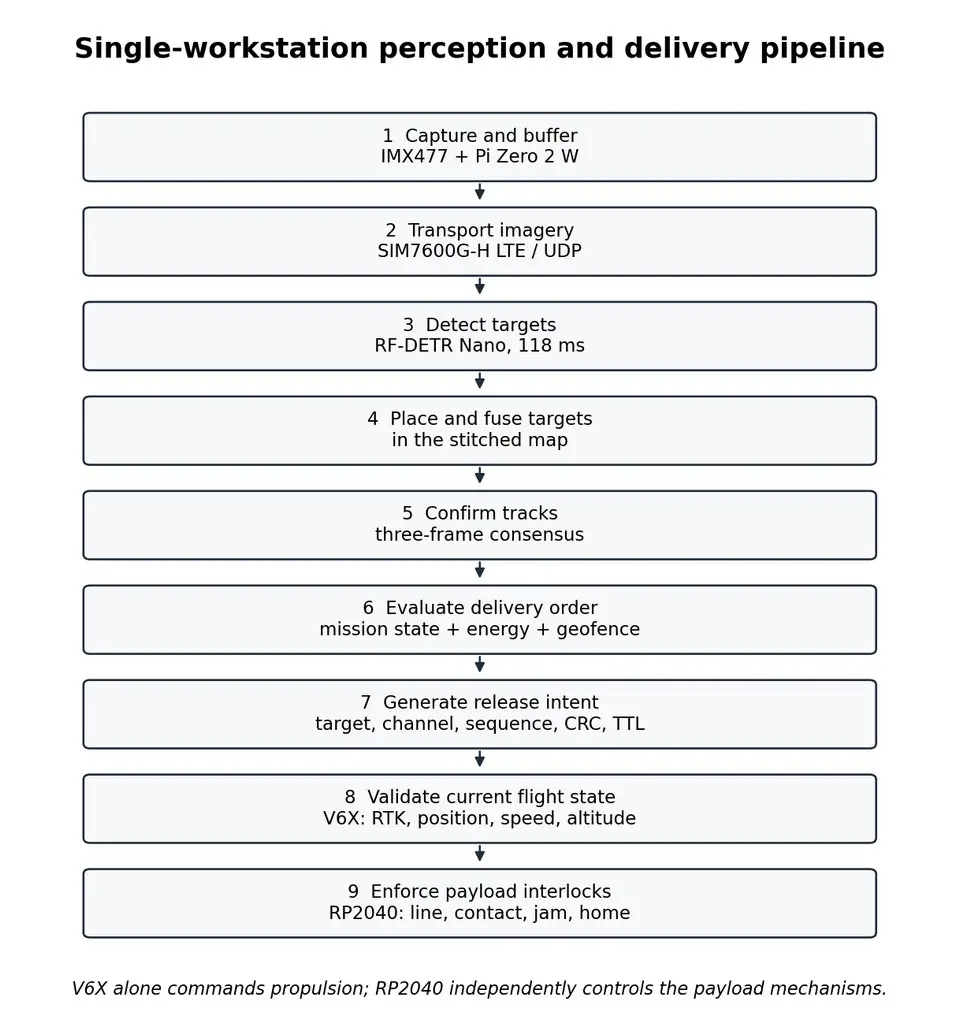

From 84 images to one risk map
2026 validation | Perception

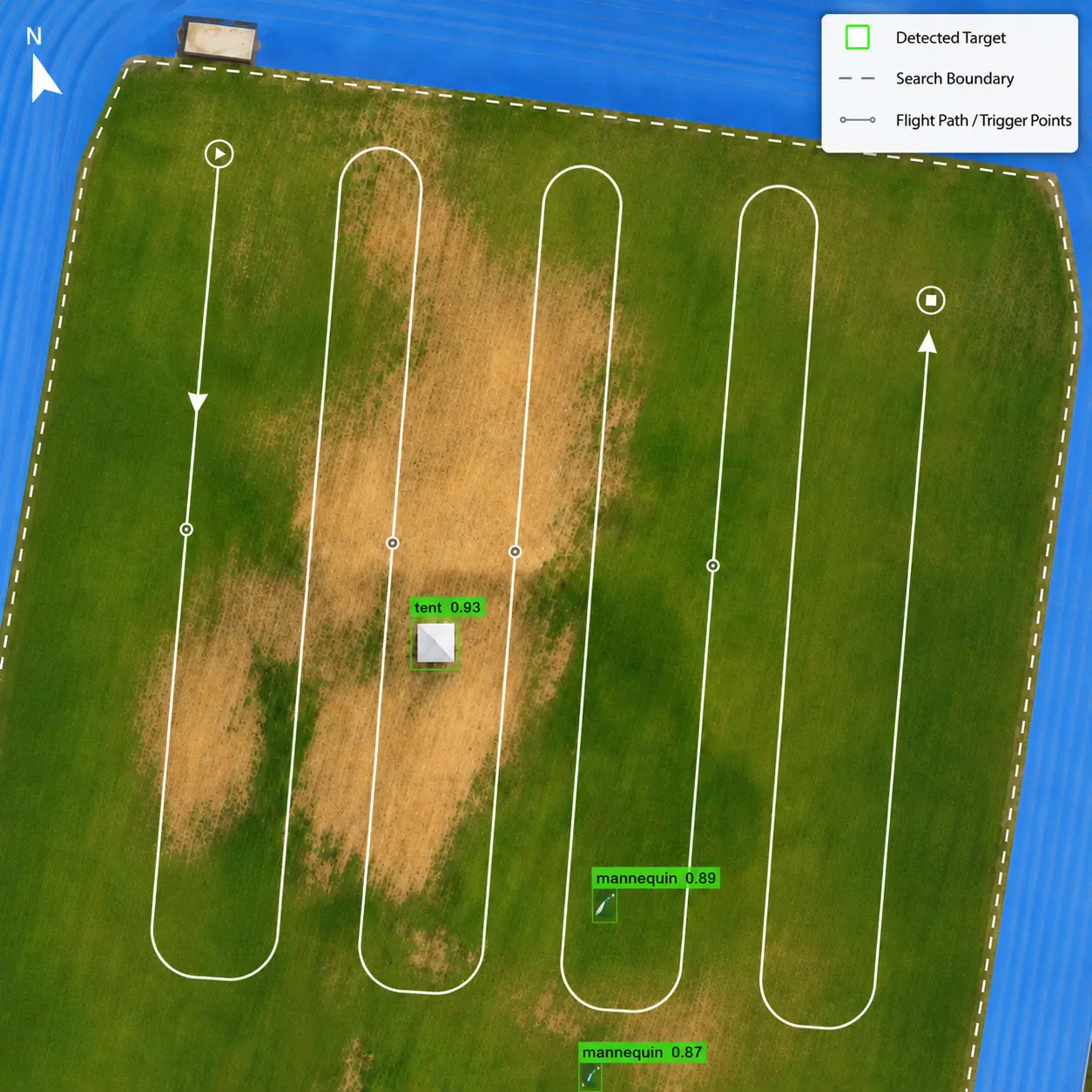

A 150 ft AGL sortie produced the stitched MAP-001 orthomosaic and found all three planted targets.
RF-DETR Nano was evaluated separately on 87 labeled instances from actual flight data so the three-target map demonstration was not treated as the full quantitative dataset.
Sixty releases above 150 ft AGL
2026 validation | Payload delivery
Both independent channels completed thirty flight deliveries in winds from 2 to 8 m per second.
All 60 payloads landed within 50 ft with a 4.2 m mean radial error. The finite perfect sample is reported with its uncertainty rather than as proof of perfect underlying reliability.
